Project Updates
Round 1 - Bundle 1

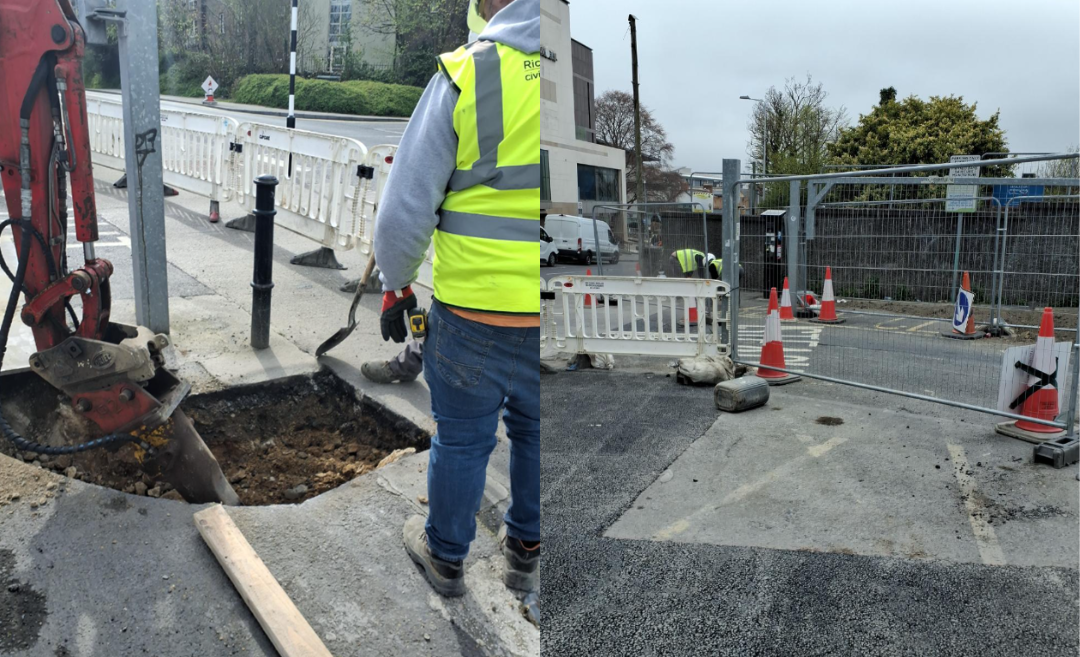

Friday, 10th April 2026

1. Works elements completed / ongoing:
• Drainage works around the mini roundabout have been completed.
• Pavement works are currently underway at the entrance to Carysfort National School and are scheduled to be completed by Saturday, 11th April 2026.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath, kerbing works and Tree Pits installation works on Convent Road.
• Implement the next phases of the Traffic Management Plan as required.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Works on Convent Road will continue to operate under restricted working hours (10:00–16:00).
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 17th April 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news
Friday, 03rd April 2026

1. Works elements completed / ongoing:
• Drainage works are completed.
• Footpath upgrades and tactile paving works are underway.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath and kerbing works around the roundabout, and then proceed to Convent Road, starting with the works at the Carysfort National School entrance.
• Implement the next phases of the Traffic Management Plan as required.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Works at the mini‑roundabout area will continue to operate under restricted working hours (10:00–16:00).
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 10th April 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news
Friday, 27th March 2026

1. Works elements completed / ongoing:
• Drainage works are completed.
• Footpath upgrades and tactile paving works are underway.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath and kerbing works around the roundabout.
• Implement the next phases of the Traffic Management Plan as required.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Works at the mini‑roundabout area will continue to operate under restricted working hours (10:00–16:00).
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 03rd April 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news

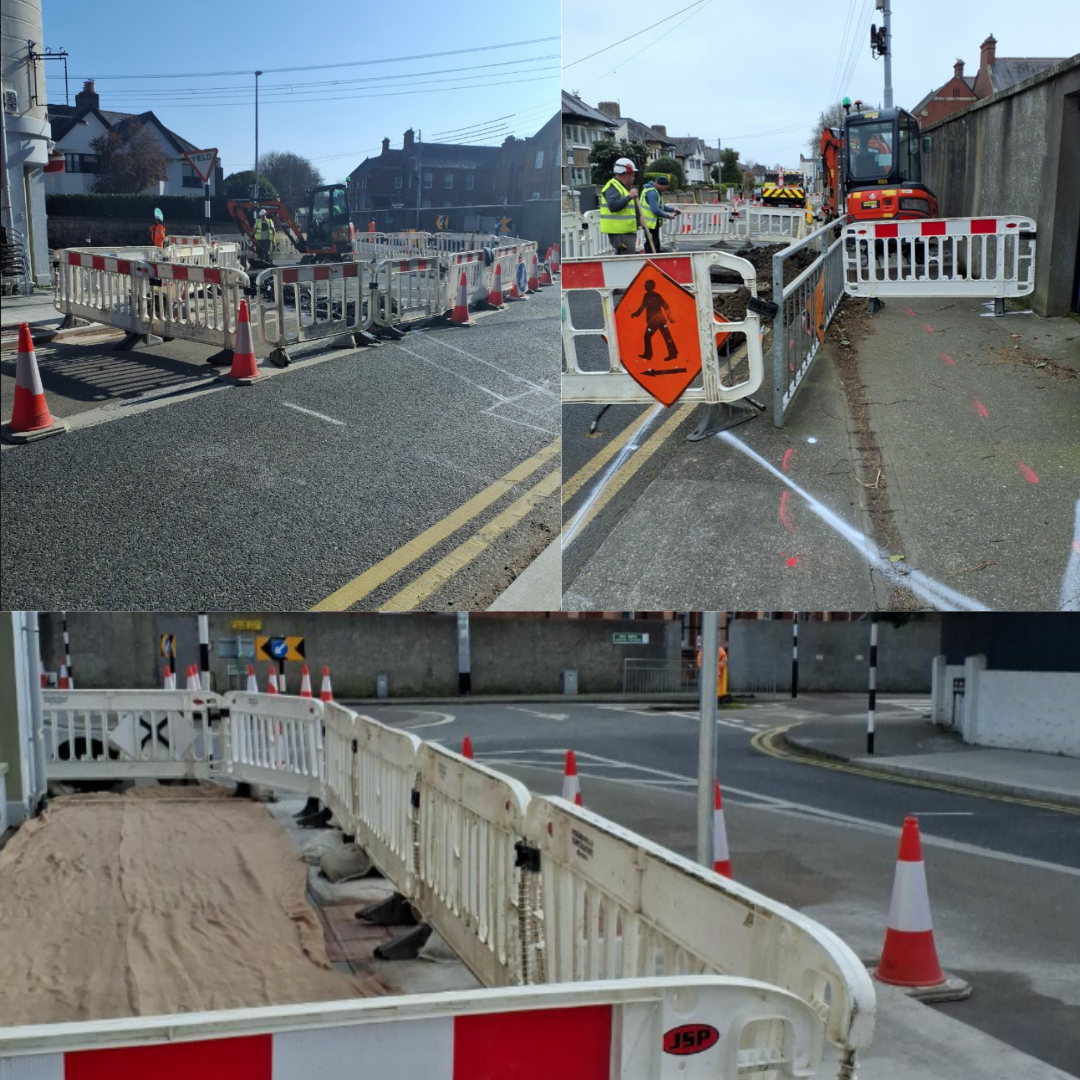

Friday, 20th March 2026

1. Works elements completed / ongoing:
• Drainage works are in progress.
• Footpath upgrades and tactile paving works are underway.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath, kerbing, and drainage works around the roundabout.
• Implement the next phases of the Traffic Management Plan as required.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Works at the mini‑roundabout area will continue to operate under restricted working hours (10:00–16:00).
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 27 March 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news

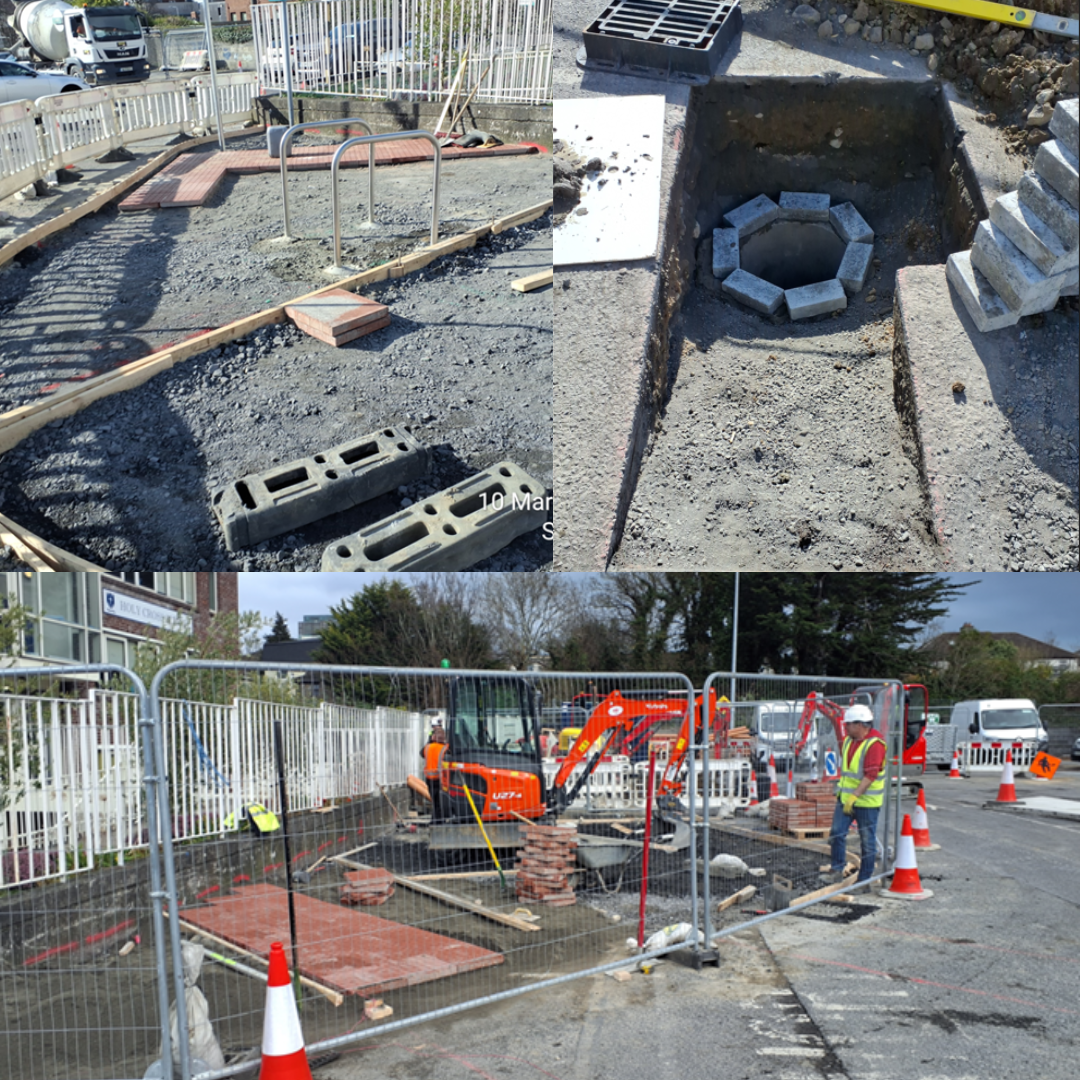

Friday, 13th March 2026

1. Works elements completed / ongoing:
• Construction works at the mini‑roundabout have commenced.
• Footpath upgrades and tactile paving works are underway.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath, kerbing, and drainage works around the roundabout.
• Implement the next phases of the Traffic Management Plan as required.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Works at the mini‑roundabout area will continue to operate under restricted working hours (10:00–16:00).
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 20 March 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news.

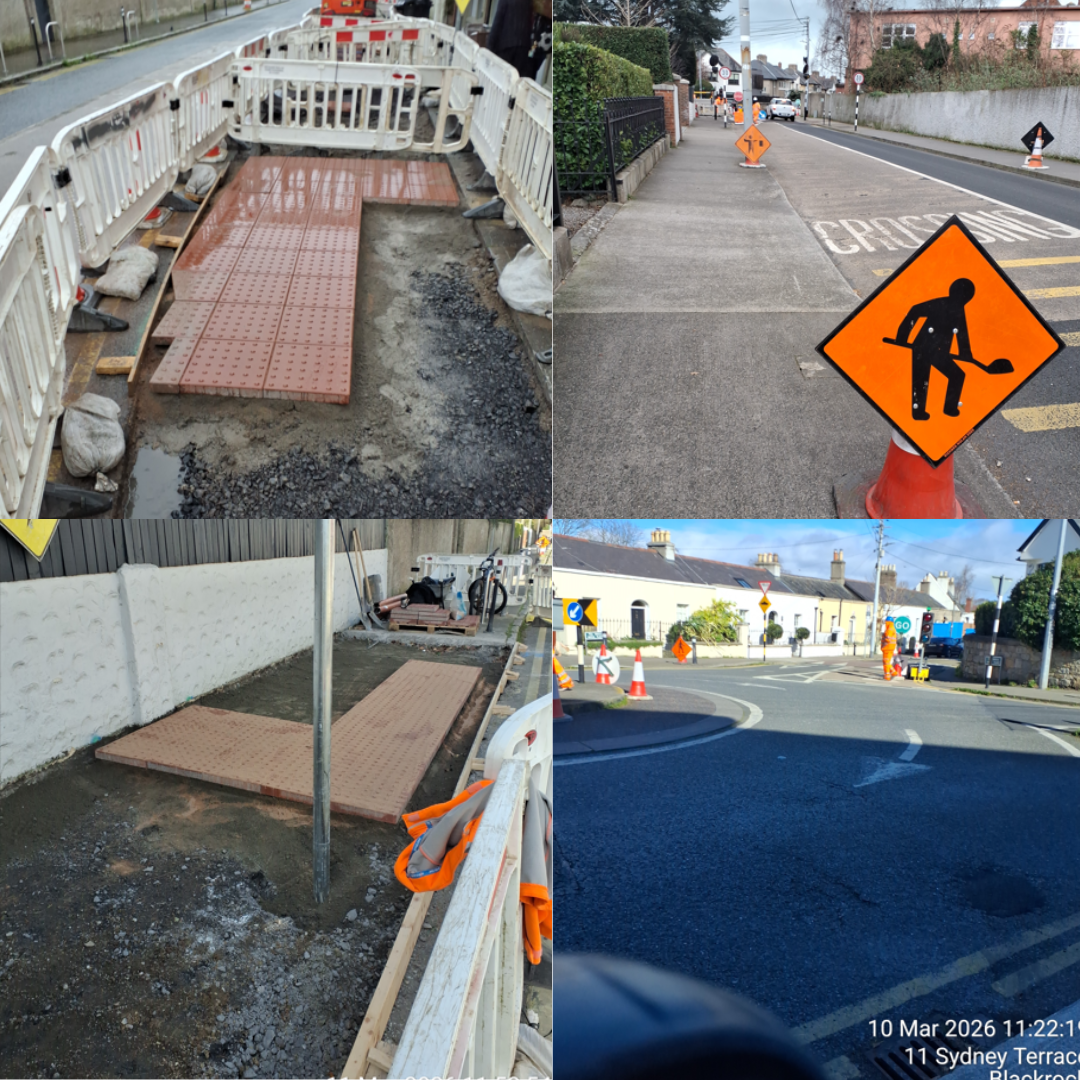

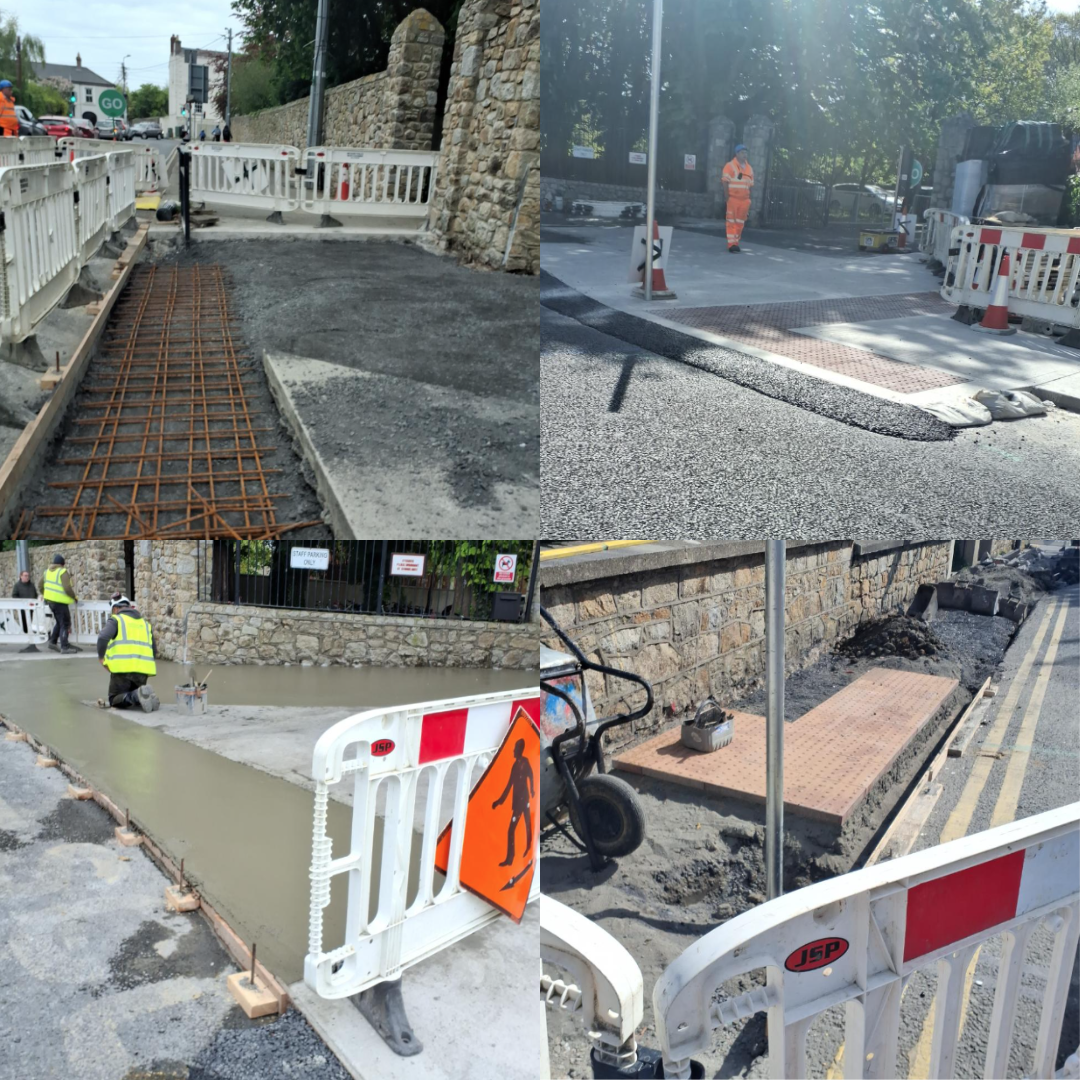

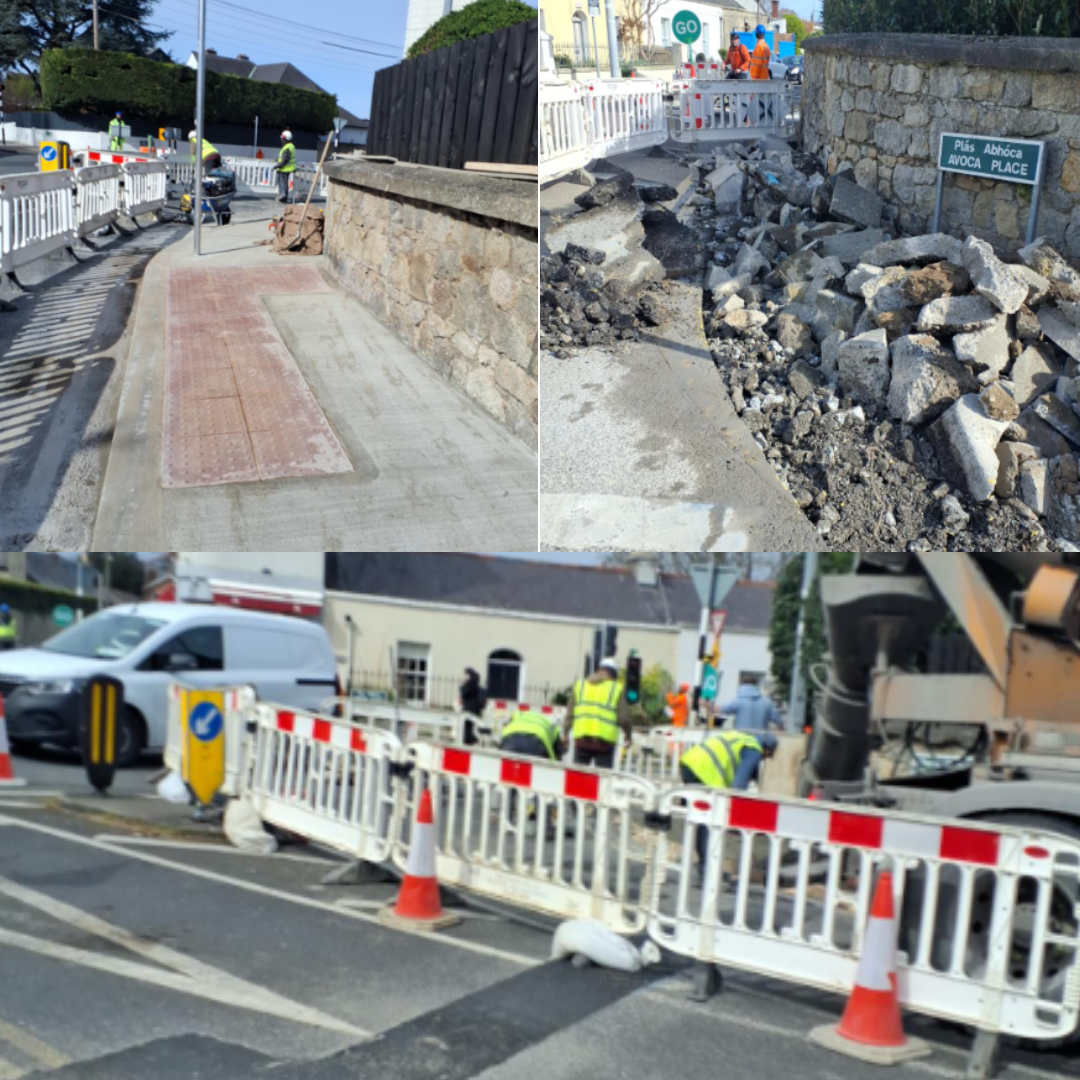

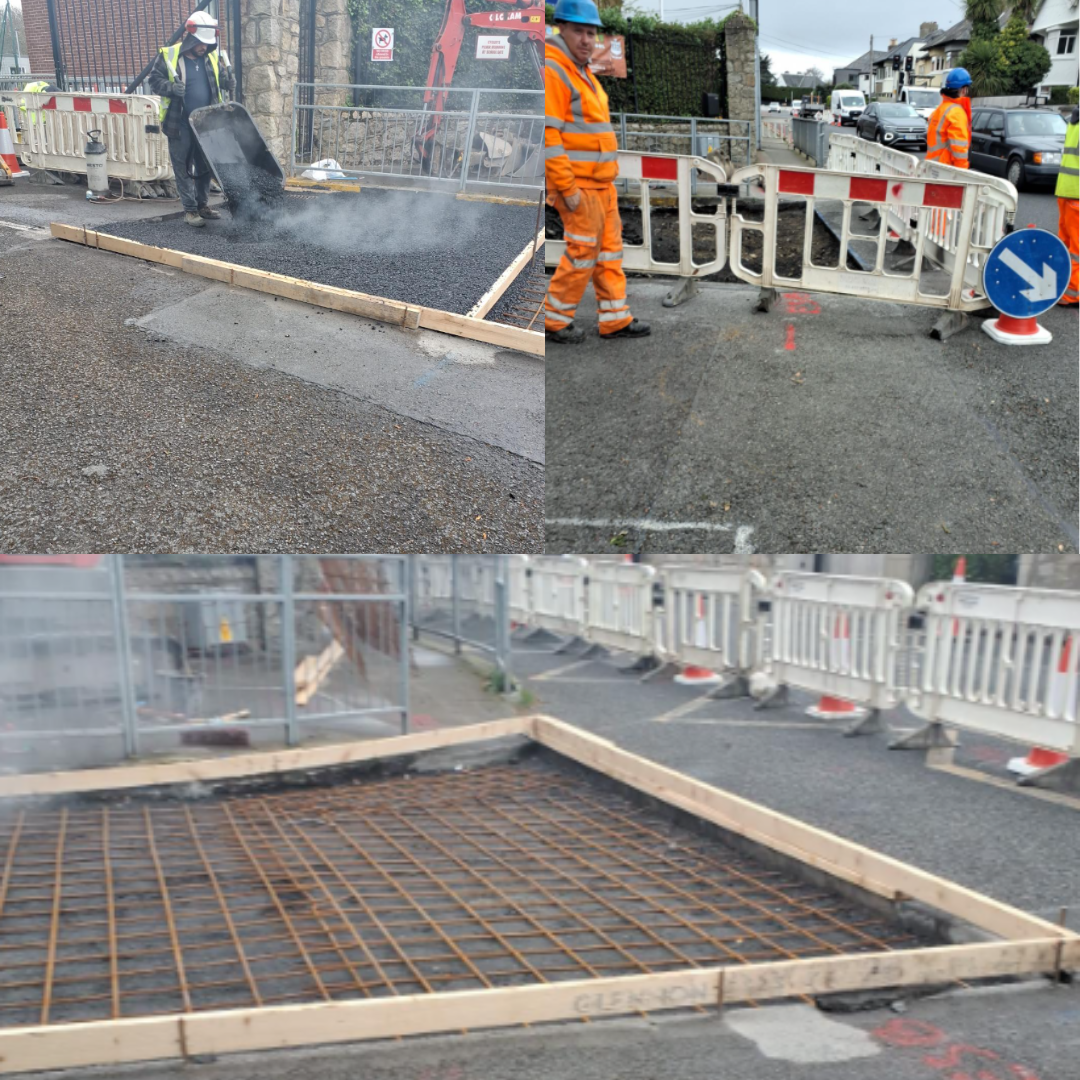

Friday, 10th April 2026

1. Works elements completed / ongoing:
• Bike shelter and bike stand installation works are ongoing.
• Installation of one gully has been completed and connected to the existing manhole.
2. Works lookahead:
Sandyford Road Car Park
• Continue bike shelter and bike stand installation works
• Continue rain garden installation works.
• Line marking works are scheduled to take place.
• Road pavement works are scheduled to take place.
• Maintain temporary traffic management and pedestrian access arrangements within the car park.
Upper Kilmacud Road
• Construction works are planned to commence next week at Upper Kilmacud Road.
• The works include upgrades to footpaths, tactile paving, drainage improvements, kerbing, and accessibility enhancements.
3. Early warning items:
Sandyford Road Car Park
• No significant early warning items at present.
• A small number of car park spaces will continue to remain temporarily unavailable during construction.
• Localised pedestrian diversions may be required as works progress.
• Construction works are planned to commence next week at Upper Kilmacud Road.
Upper Kilmacud Road
• Construction works are planned to commence next week at Upper Kilmacud Road.
• To minimise disruption, all traffic‑impacting works will take place between 10:00 and 16:00, avoiding busy school and commuter peak times. Pedestrian access to the school will be maintained.
4. Other:
• The next update is on Friday, 17th April 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news
Friday, 03rd April 2026

1. Works elements completed / ongoing:
• Bike shelter and bike stand installation works are ongoing.
• 1 catchpit manhole, 2 gullies and pipes and 2 gully gratings are installed and replaced.
2. Works lookahead:
• Continue bike shelter and bike stand installation works
• Continue rain garden installation works.
• Drainage works are scheduled to include the installation of 1 gully and the associated pipework.
• Line marking works are scheduled to take place.
• Road pavement works are scheduled to take place.
• Maintain temporary traffic management and pedestrian access arrangements within the car park.
3. Early warning items:
• No significant early warning items at present.
• A small number of car park spaces will continue to remain temporarily unavailable during construction.
• Localised pedestrian diversions may be required as works progress.
4. Other:
• The next update is on Friday, 10th April 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news

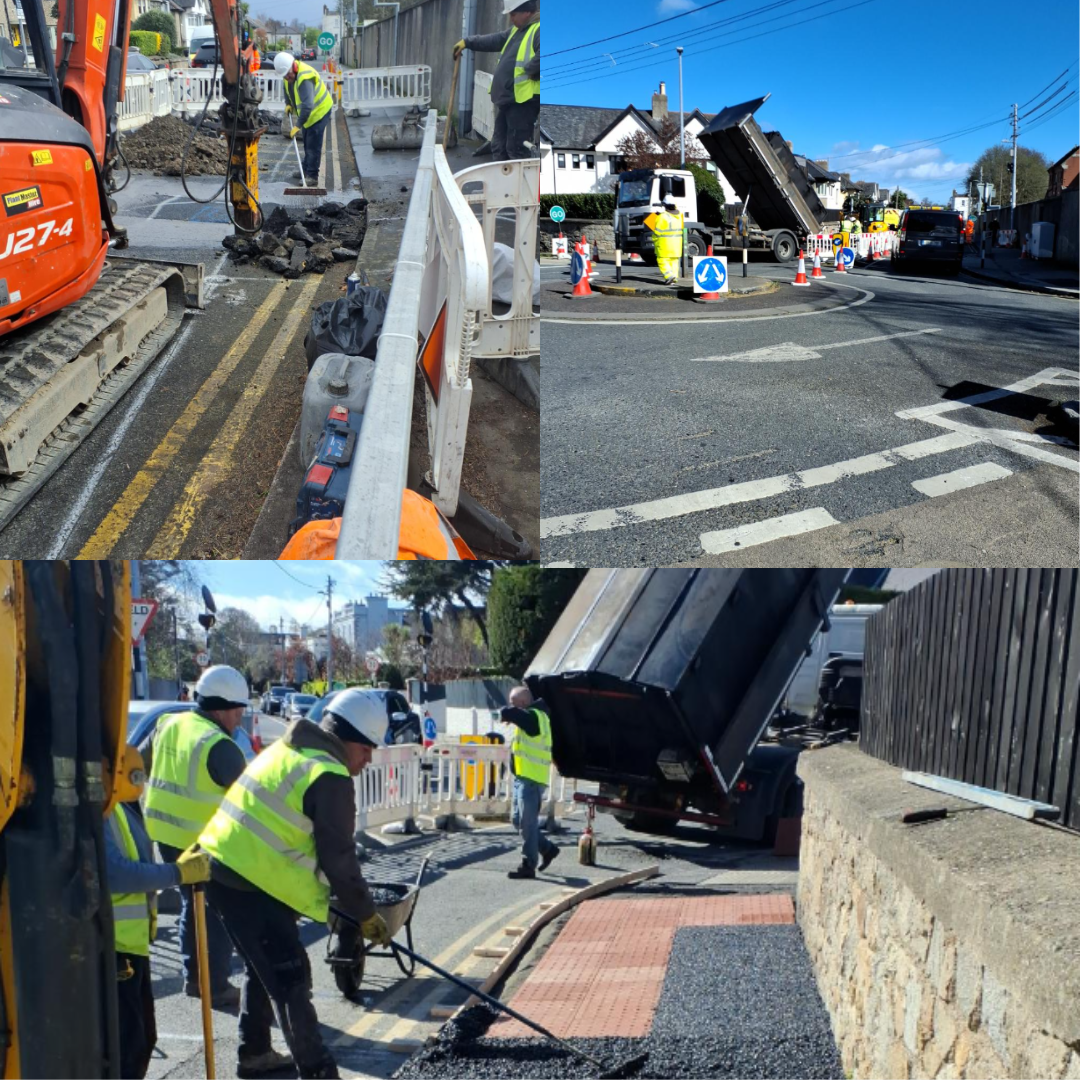

Friday, 27th March 2026
1. Works elements completed / ongoing:
• Bike shelter and bike stand installation works are ongoing.
• Nine pencil bollards were installed together with the RS76 units.
2. Works lookahead:
• Continue bike shelter and bike stand installation works.
• Continue rain garden installation works.
• Drainage works are scheduled to include the installation of 1 catchpit, 2 gullies, and the associated pipework.
• Line marking works are scheduled to take place.
• Maintain temporary traffic management and pedestrian access arrangements within the car park.
3. Early warning items:
• No significant early warning items at present.
• A small number of car park spaces will continue to remain temporarily unavailable during construction.
• Localised pedestrian diversions may be required as works progress.
4. Other:
• The next update is on Friday, 03rd April 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news
Friday, 20th March 2026

1. Works elements completed / ongoing:
• Bike shelter and bike stand installation works are ongoing.
• Rain garden installations are in progress.
2. Works lookahead:
• Continue bike shelter and bike stand installation works
• Continue rain garden installation works.
• Line marking works are scheduled to take place.
• Maintain temporary traffic management and pedestrian access arrangements within the car park.
3. Early warning items:
• No significant early warning items at present.
• A small number of car park spaces will continue to remain temporarily unavailable during construction.
• Localised pedestrian diversions may be required as works progress.
4. Other:
• The next update is on Friday, 27 March 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news
Friday, 13th March 2026

1. Works elements completed / ongoing:
• Drainage upgrades are ongoing within the Sandyford Road Car Park zone.
• Rain garden installations are in progress.
• Footpath works are underway.
• New street furniture installations are in progress.
• Pedestrian access is being maintained throughout the works area.
2. Works lookahead:
• Continue drainage installation and complete remaining rain garden works.
• Progress footpath finishing works.
• Continue installation of street furniture.
• Maintain temporary traffic management and pedestrian access arrangements within the car park.
3. Early warning items:
• No significant early warning items at present.
• A small number of car park spaces will continue to remain temporarily unavailable during construction.
• Localised pedestrian diversions may be required as works progress.
4. Other:
• The next update is on Friday, 20 March 2026.
• Weekly traffic updates: https://www.dlrcoco.ie/traffic-management/traffic-news
Friday, 10th April 2026

1. Works elements completed / ongoing:
• Footpath upgrade works are ongoing.
• 2 Tree pits have been installed.
• 1 Gully has been installed and connected to the existing manhole.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
Dunedin Terrace
• Continue footpath upgrade works.
• Maintain safe pedestrian access throughout all phases of construction.
Monkstown Grove
• Construction works will commence on Monkstown Grove from next week.
• The works include upgrades to footpaths, tactile paving, drainage improvements, kerbing, and accessibility enhancements.
3. Early warning items:
Dunedin Terrace
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
Monkstown Grove
• Construction works are planned to commence next week at Upper Kilmacud Road.
• To minimise disruption, all traffic‑impacting works will take place between 10:00 and 16:00, avoiding busy school and commuter peak times. Pedestrian access to the school will be maintained.
4. Other:
• The next update is on Friday, 17th April 2026.
• For weekly traffic news updates, visit https://www.dlrcoco.ie/traffic-management/traffic-new
Friday, 03rd April 2026

1. Works elements completed / ongoing:
• Public lighting ducting works are completed.
• Footpath upgrade works are ongoing.
• Tree pit installed.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath upgrade works.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 10th April 2026.
• For weekly traffic news updates, visit https://www.dlrcoco.ie/traffic-management/traffic-new

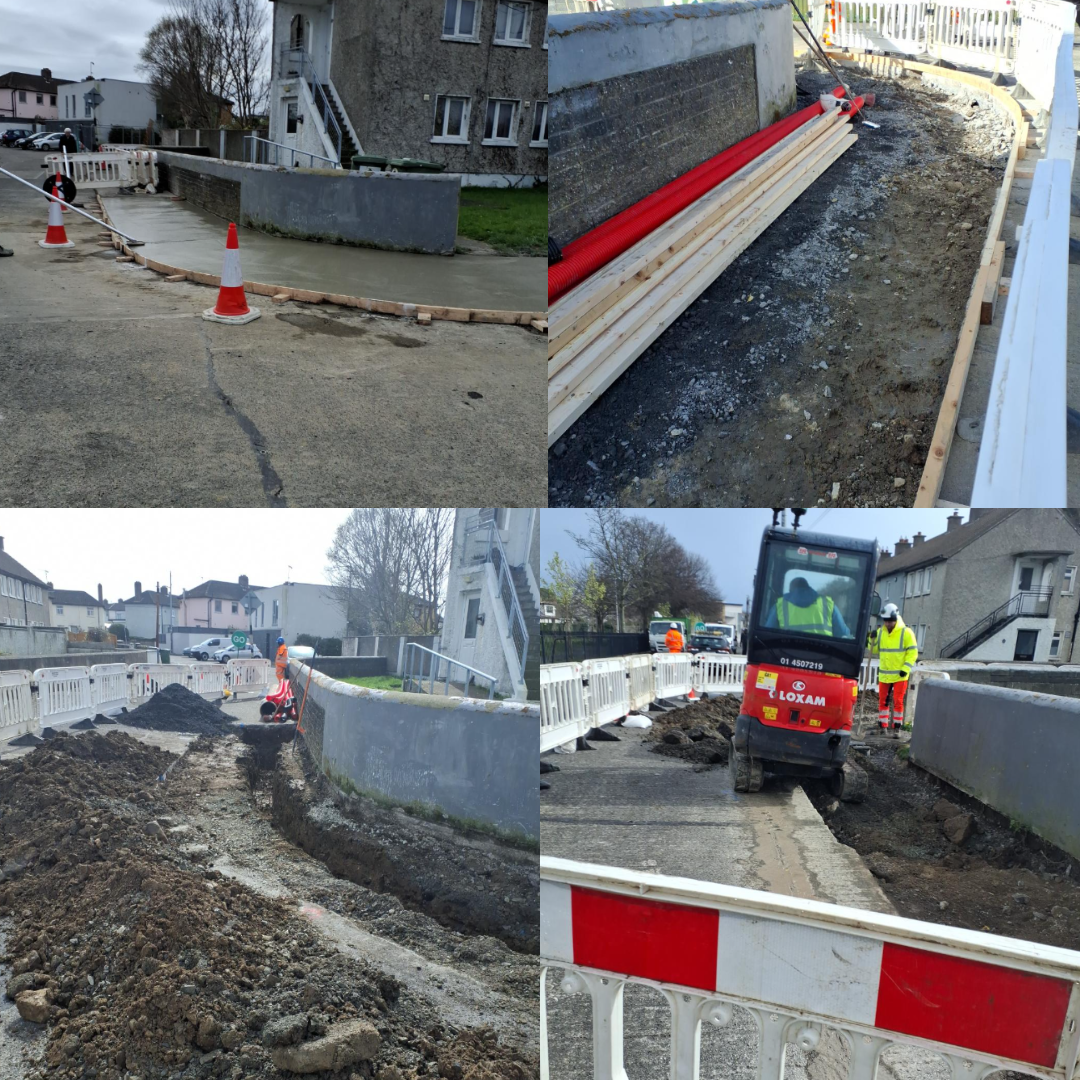

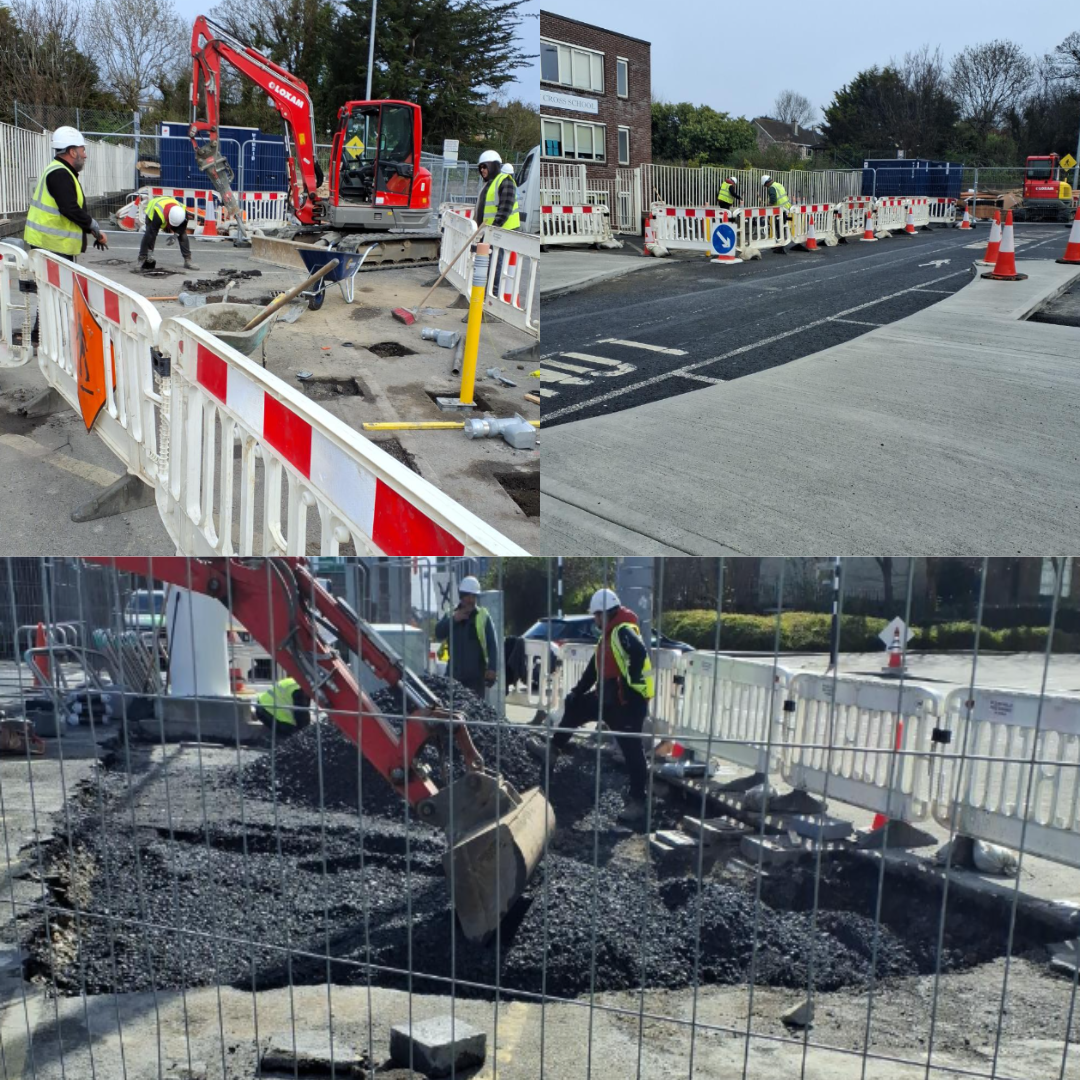

Friday, 27th March 2026
1. Works elements completed / ongoing:
• Public lighting ducting works are ongoing.
• Footpath upgrade works are ongoing.
• Pedestrian access to the school remains fully maintained.
2. Works lookahead:
• Continue footpath upgrade works.
• Continue public lighting ducting works.
• Maintain safe pedestrian access throughout all phases of construction.
3. Early warning items:
• Localised delays may occur during certain construction phases, but disruption is expected to remain minimal.
4. Other:
• The next update is on Friday, 03 April 2026.
• For weekly traffic news updates, visit https://www.dlrcoco.ie/traffic-management/traffic-new
- St. Patrick's Girls School and Boys National School, Hollypark
- St. Kevin's National School, Sallynoggin
Project Overview
Dún Laoghaire-Rathdown County Council is working with the National Transport Authority (NTA) to deliver their “Safe Routes to School” (SRTS) Programme, the aim of which is to improve safety at school entrances, improve access routes to schools and encourage as many pupils as possible in primary and post-primary schools to walk and cycle.

The SRTS Programme includes the delivery of “School Zones” consisting of public realm upgrades outside schools, which will:
- Reduce vehicular congestion at school gates.
- Encourage drivers to slow down in the vicinity of a school.
- Reduce vehicle drop-offs, pick-ups and vehicles idling at school gates.
- Highlight the presence of schools and their vulnerable road users.
- Provide the public with cleaner air, safer streets, and more vibrant and inclusive public spaces.

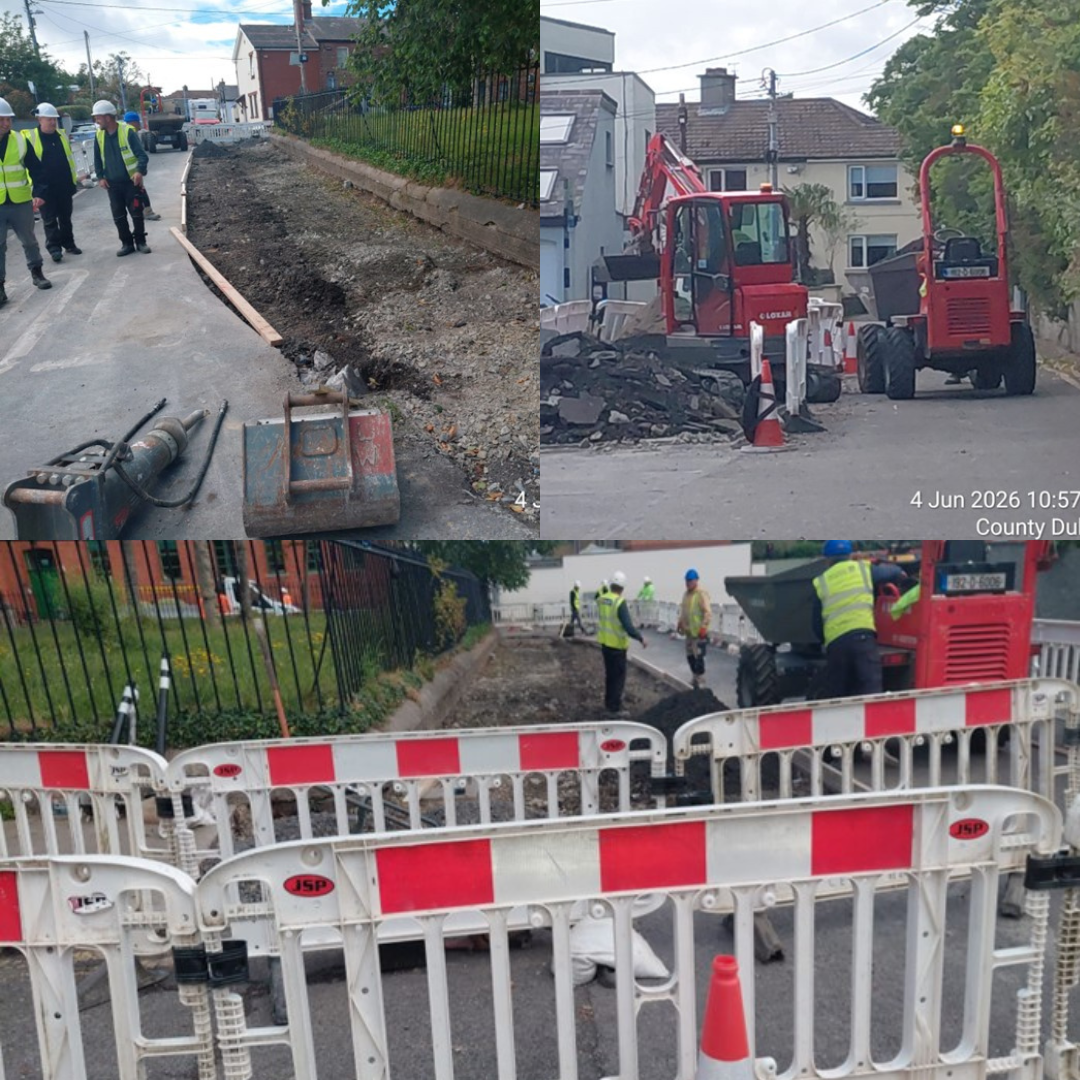

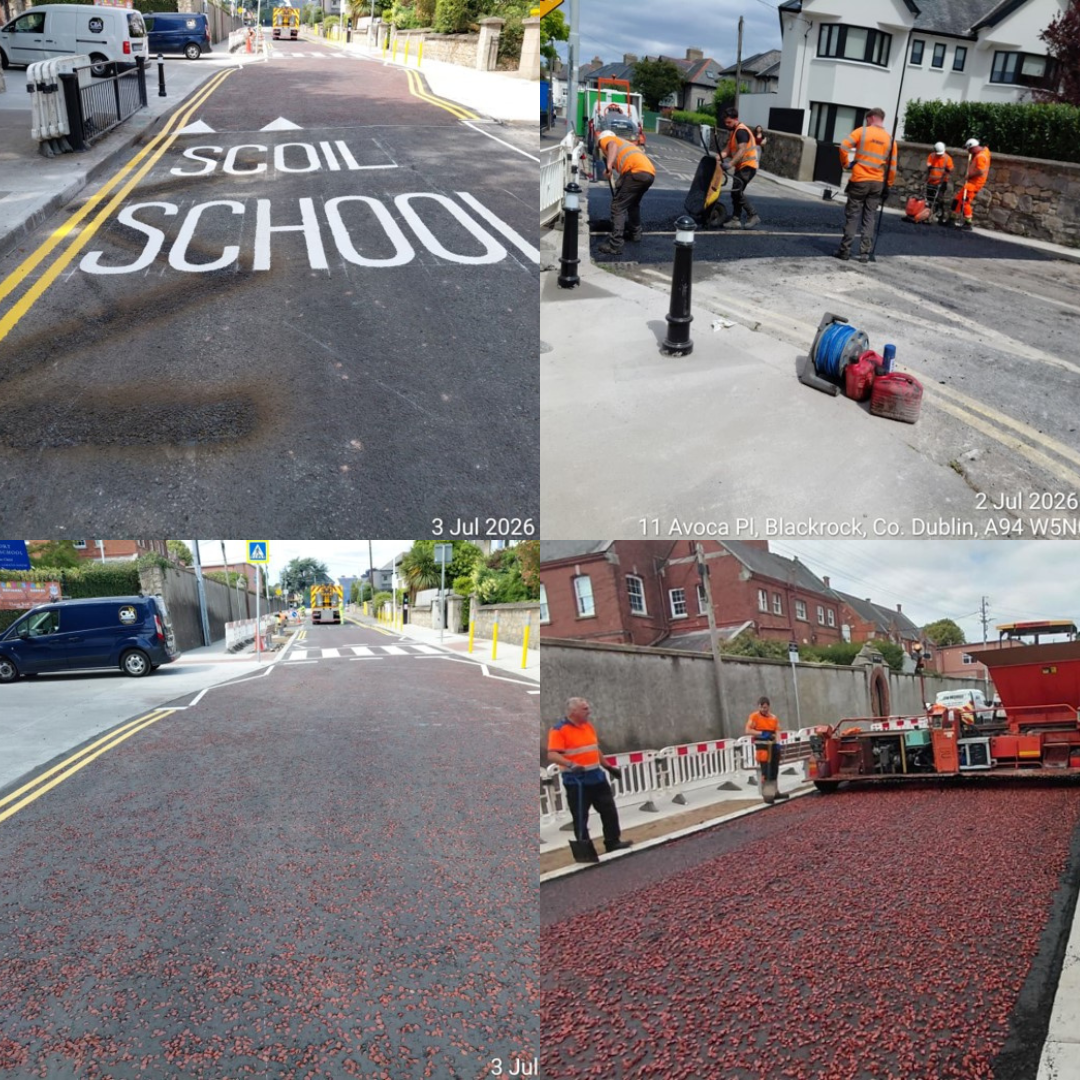

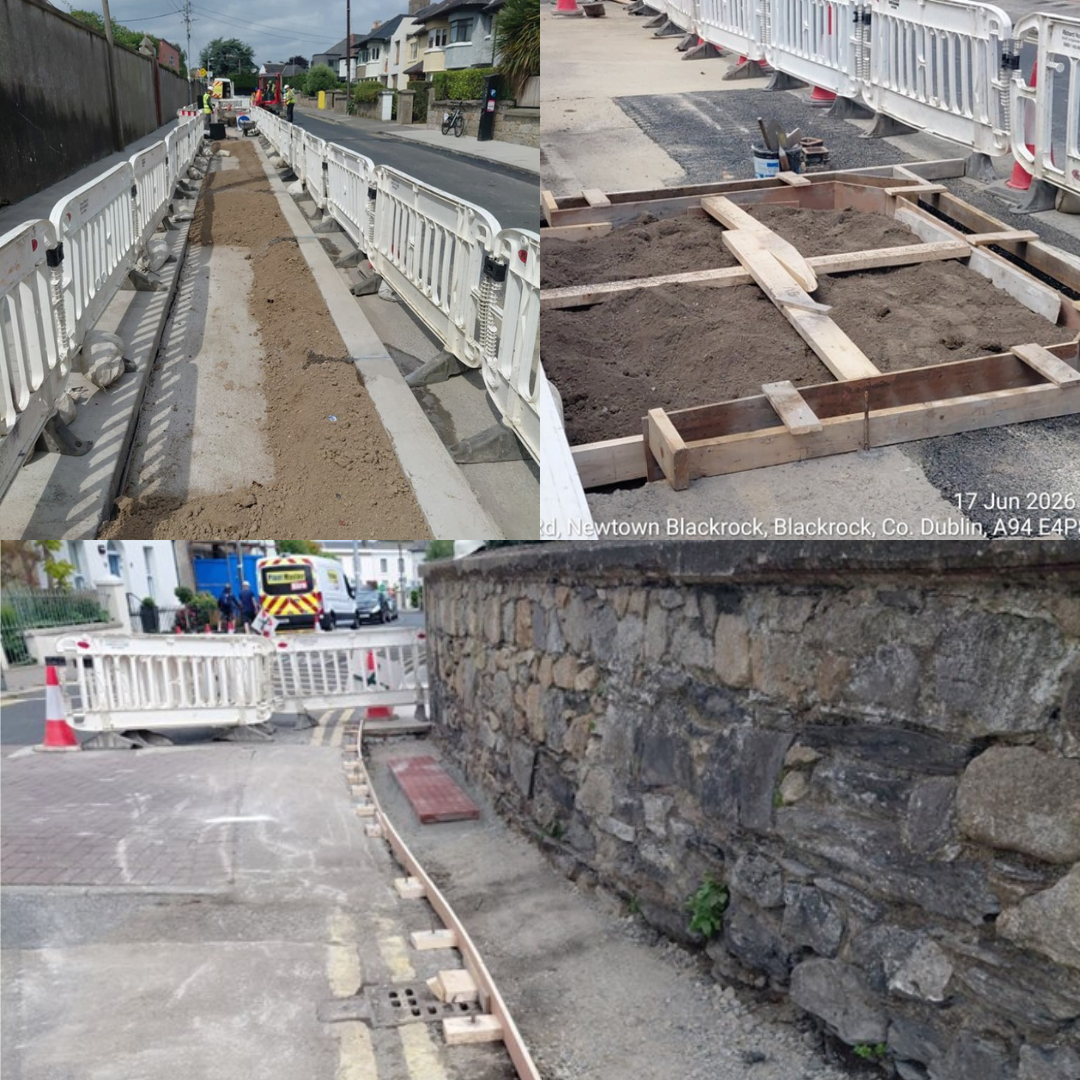

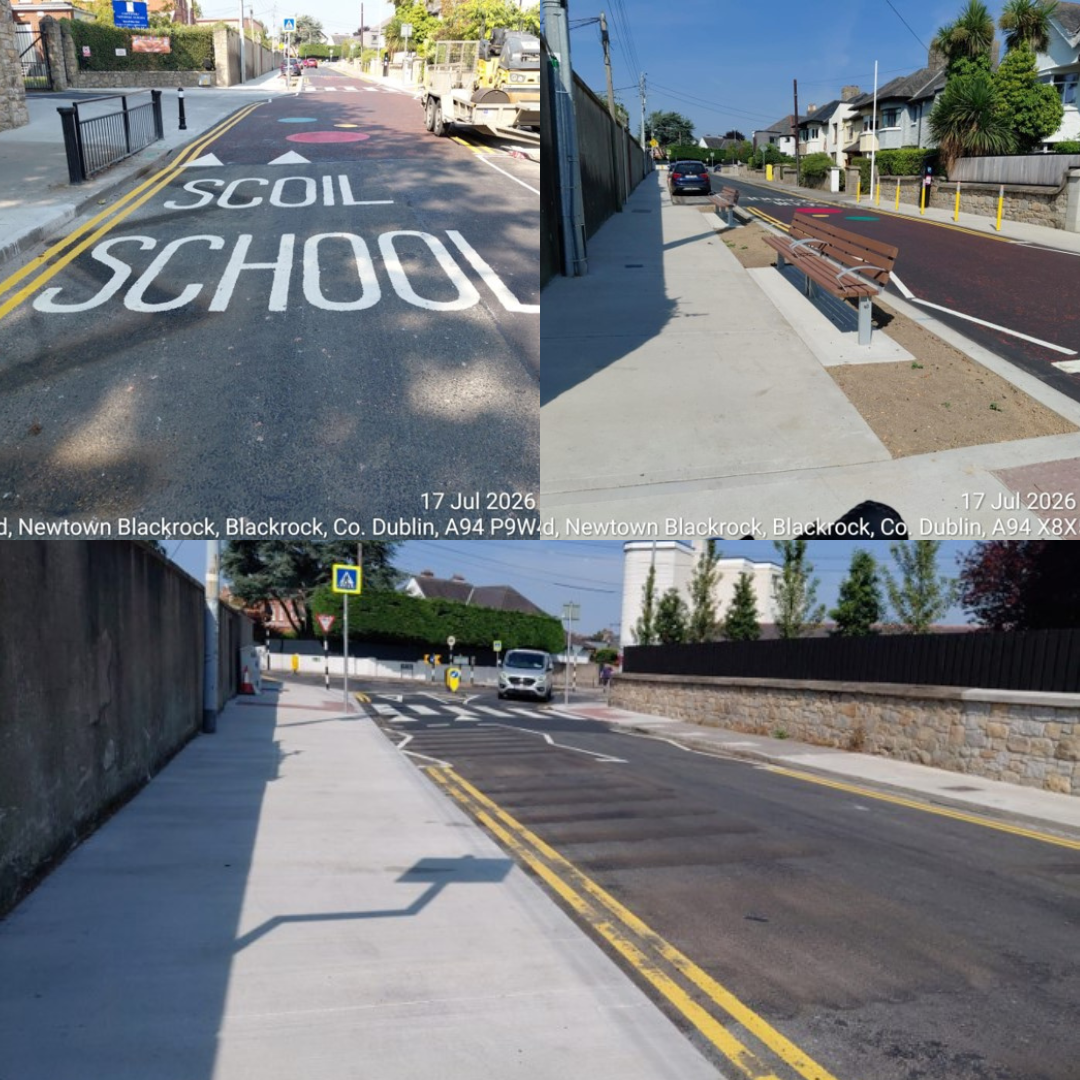

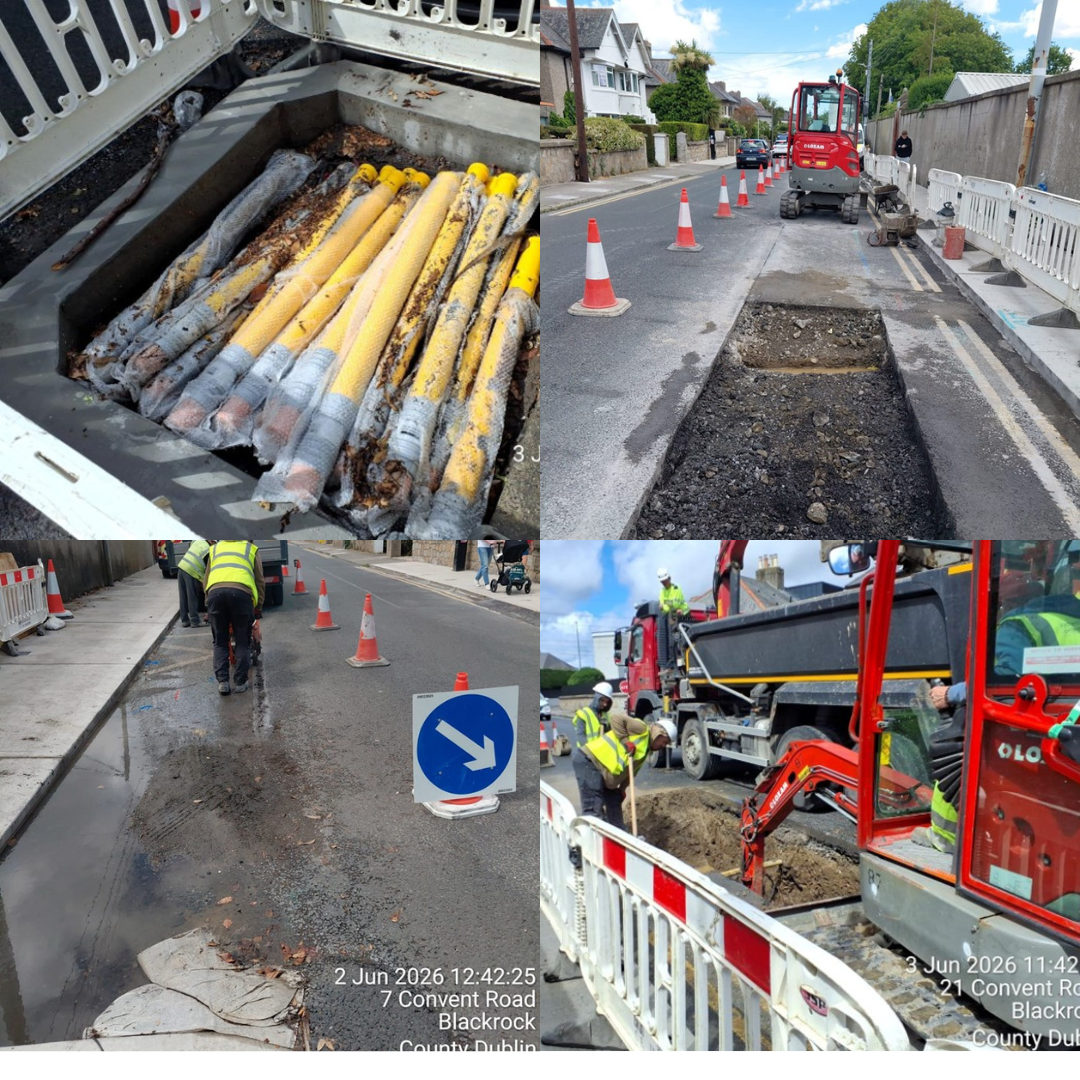

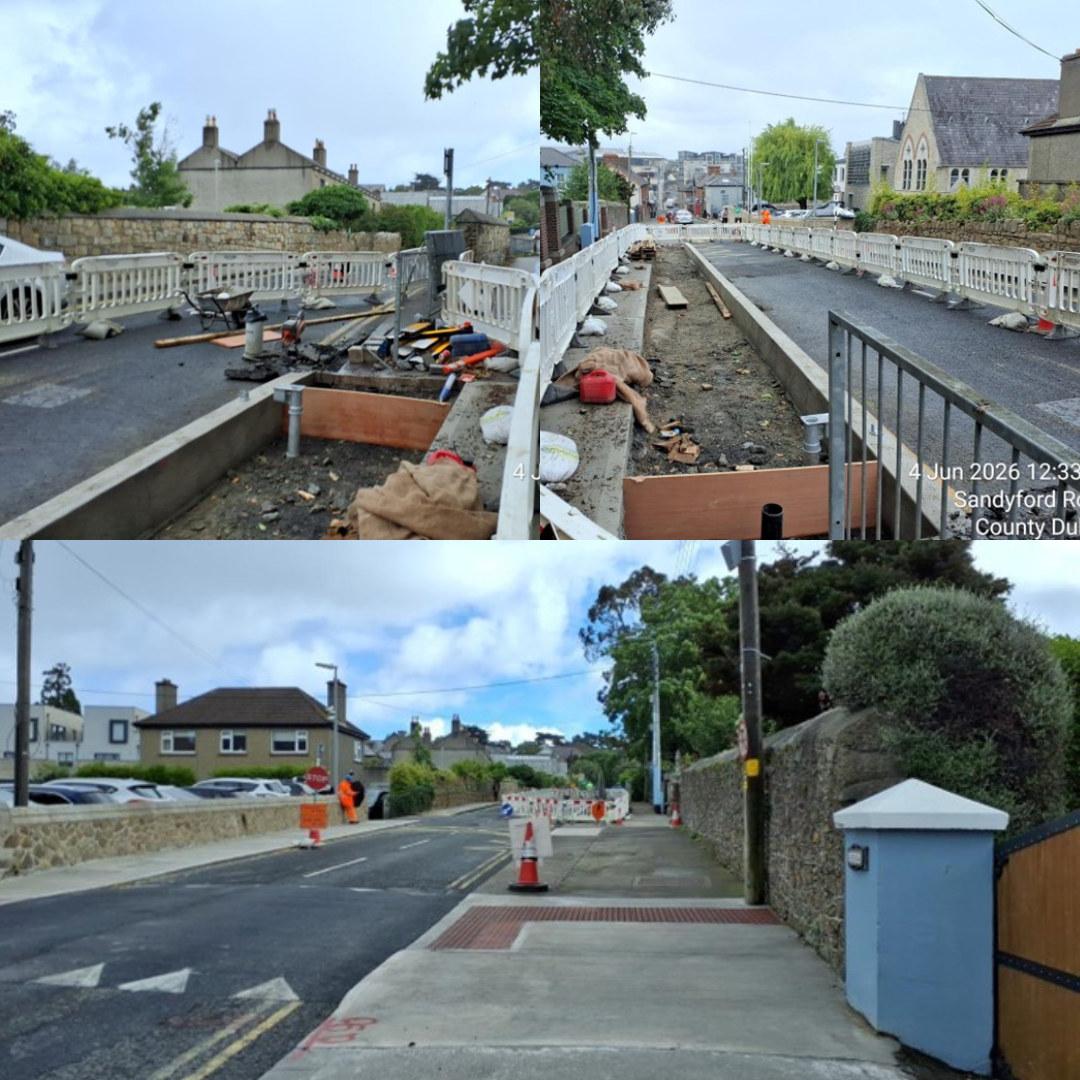

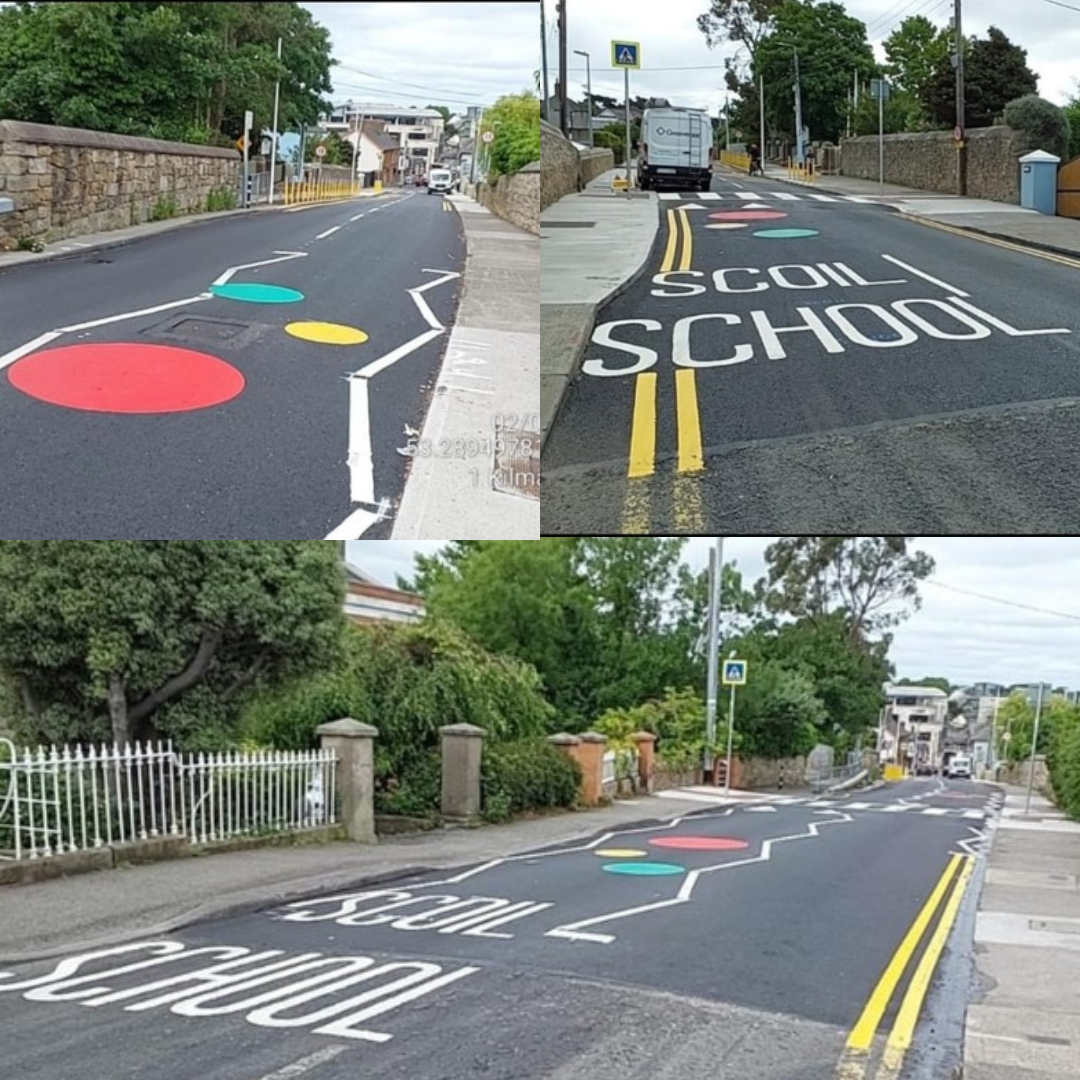

The proposed interventions at each school are based on survey findings, audits, and consultations with the schools, developed by SRTS An Taisce's Infrastructure Officer in collaboration with the Local Authority and the National Transport Authority (NTA).
A list of schools in DLR is shown in the table below:
